Successful Odoo ERP Implementation: A Complete Guide for SMB Owners and Founders (2026)

The Odoo implementation process for SMBs and mid-sized firms: phases, rollout strategies, real cost ranges, a worked cost example and mistakes to avoid.

Siddharth JambukiyaSiddharth JambukiyaOdoo Techno-Functional Consultant
August 4, 2026Updated October 31, 202613 min read51 views
Successful Odoo ERP Implementation: A Complete Guide for SMB Owners and Founders (2026) cover

As an owner or founder, you do not need to configure Odoo, but you do need to make the calls that decide whether it succeeds. Our Odoo implementation services cover scoping to go-live, and this guide explains the decisions you own.

This guide is for owners, CFOs and operations heads at small and mid-sized companies, roughly 10 to 150 staff. If you want the task-by-task list for your project team, use our Odoo implementation checklist from planning to go-live.

What does the Odoo implementation process involve?

The Odoo implementation process is the work of configuring, adjusting and rolling out Odoo so it runs your real operations, from sales and inventory to accounting. It is a business project with software in it, not a software install.

For an owner, that means mapping how the business works, deciding what to change, moving your data, training the team and going live without stopping trade. The software is the easy part; process and people are where projects succeed or fail.

Mid-sized companies feel this more than small ones. More departments, more users and more legacy data mean more decisions, and each one waits on someone with authority. The rest of this guide shows where those decisions sit.

What are the phases of the Odoo implementation process?

Every Odoo implementation moves through the same eight phases: discovery, design, build, data migration, testing, training, go-live and support. Knowing them helps you spot where a project is drifting.

PhaseWhat happensWhat the owner watches
DiscoveryMap processes, set goals and scopeScope is written down and agreed
DesignPlan configuration and any custom workEach customization has a business reason
BuildSet up apps, build custom codeProgress against the agreed scope
Data migrationClean, map and load your dataData is accurate, not just moved
TestingRun real business scenariosYour team tests, not just the vendor
TrainingPrepare each role to use OdooPeople are ready, not just informed
Go-liveSwitch to OdooA rollback plan and cutover date exist
SupportFix, adopt, improveAdoption and open issues shrink each week

On a mid-size project of 8 to 14 weeks, discovery and design usually take the first few weeks, and testing should never be squeezed into the last few days. Our guide to user acceptance testing for Odoo 19 and 20 covers that phase in depth.

These phases match our Odoo ERP implementation methodology, which breaks each one into tasks, owners and sign-offs.

Odoo implementation strategies: which rollout fits your business?

Odoo implementation strategies: Which rollout fits your business?

There are four main Odoo implementation strategies: big-bang, phased, parallel run and hybrid, and the right one depends on your risk tolerance and cash flow. This is the first big decision an owner makes.

FactorBig-bangPhasedParallel run
Speed to full useFastestMediumSlowest
Implementation costLowestMediumHighest
Risk if something breaksHits every team at onceLimited to one areaLowest, old system still runs
Staff workloadOne intense cutoverSpread over phasesDouble entry for weeks
Best forSmall, simple businessesMost SMBs and mid-sized firmsFinance-heavy or regulated firms
Typical first scopeAll apps on day oneSales, Inventory, Accounting firstAccounting run side by side

A hybrid blends these, often a phased rollout with a short parallel run on accounting. For a mid-sized company with several departments, that hybrid is usually the safest path.

Choose by risk, not by speed. If a bad week would seriously hurt the business, favor phased or parallel; if you are small and nimble, big-bang can work.

How long does an Odoo implementation take, and what does it cost?

A small Odoo implementation takes 4 to 8 weeks and costs $3k to $9k, while a mid-size project takes 8 to 14 weeks and costs $9k to $27k, with Odoo licenses billed separately. The variables are scope, customization, data and users.

These are the ranges we publish on our Odoo implementation cost page. They are ranges, not quotes:

Project sizeUsersTimelineImplementation cost
Starter5 to 254 to 8 weeks$3k to $9k
Growth (mid-size)25 to 1008 to 14 weeks$9k to $27k
Enterprise100+12 to 24 weeks$27k to $150k+

A single-entity rollout on standard apps lands at the Starter end. Multi-warehouse, custom modules and two or three integrations push a project into Growth. For the week-by-week view, see how long an Odoo implementation takes by size and scope.

Plan for implementation and support to matter as much as licenses, and treat an unusually low quote with suspicion. It usually means testing, training or data work has been left out.

Odoo implementation cost for a mid-sized company: a worked example

For a 45-user distributor, our cost drivers point to a quote near the middle of the Growth range, plus about $33k a year in Custom plan licenses. The example below is illustrative, built from our published drivers, not a quote.

The company: one legal entity, two warehouses, 45 Odoo users, a Shopify store and a shipping carrier to connect, and five years of history in Tally or QuickBooks. It needs one custom module for its own pricing rules.

Cost driverOur published rangeThis example (illustrative)
Apps (Sales, CRM, Purchase, Inventory, Accounting, eCommerce)$0.9k to $3k per app6 apps: $5.4k to $18k
Custom modules$1.8k to $9k each1 module: $1.8k to $9k
Integrations$1.2k to $6k each2 integrations: $2.4k to $12k
Data migration$1.2k to $9kFive years of history: $1.2k to $9k
Total if every driver hit the same endn/a$10.8k to $48k

Adding every driver at its top end gives a worst case well above our Growth range. Real scopes rarely hit the top of every line, which is why most projects of this shape are quoted within the $9k to $27k Growth range.

Licenses come on top. Integrations need Odoo's external API, which sits on the Custom plan. On the Odoo pricing page, Custom costs US$61.00 per user a month billed yearly, or US$49.00 in the first year.

For 45 users that is about $32,940 a year at the regular rate, or $26,460 in the first year. Run your own numbers in our Odoo implementation cost calculator.

Odoo Community vs Enterprise, and where to start

Odoo comes in two editions: Community is free and open source, while Enterprise is paid and adds full accounting, Studio, mobile apps and Odoo support. Most growing businesses end up on Enterprise.

Community covers core sales, inventory and basic invoicing, and it is a fair start if your needs are light and you have technical help. Enterprise adds full double-entry accounting, bank sync, Studio and vendor support.

In the US, Enterprise Standard costs US$31.10 per user a month billed yearly and Custom costs US$61.00. In India they are Rs 725 and Rs 1,350. One App Free gives unlimited users on a single app, and Light Users cost US$8.90 a month.

Where you start matters as much as the edition. Begin with the apps tied to your biggest pain, usually accounting, sales and inventory, prove value there, then add the rest in later phases. Our Odoo Community vs Enterprise comparison goes deeper.

How to choose your Odoo implementation partner

Choose an Odoo implementation partner on industry references, a clear written scope and a named team, not on the lowest price. The partner decision shapes almost every other risk in the project.

  • References: ask for clients in your industry and size, and ask them about deadlines and what broke.
  • Written scope: every app, report, integration and data set listed, with what is out of scope.
  • Staged payments: payments tied to milestones such as kickoff, pilot, go-live and hypercare.
  • Named team: the consultant and developer you meet in the sales stage should work on your project.
  • Pushback: a good partner challenges unnecessary customization instead of selling it.

Comparing several quotes? Our guide on how to compare Odoo implementation proposals gives you a scorecard.

What you and your team need to bring

A successful Odoo implementation needs four roles on your side: an executive sponsor, process owners, a data owner and a few hands-on testers. The partner builds the system; these people make sure it fits and gets adopted.

The executive sponsor is usually you, the owner or founder. You set priorities, approve or reject scope changes and unblock decisions quickly. Projects stall the moment this seat sits empty.

Process owners are your leads for sales, inventory or accounting. They explain how the work really happens and confirm the configured process matches reality, not the org chart.

A data owner cleans and approves the records you migrate: product lists, customers, vendors and opening balances. Without one, dirty data quietly becomes Odoo's problem.

Finally, name a few testers and champions who run real scenarios before go-live and help teammates after. Mid-sized firms should name one per department. Our Odoo ERP training prepares them by role.

What are the most common Odoo implementation mistakes at mid-sized companies?

The most common Odoo implementation mistakes are managerial, not technical: scope creep, dirty data, weak training, no sponsor and picking the cheapest quote. As the owner, you can prevent every one of them.

  1. Scope creep: every extra customization adds time, cost and upgrade risk, so approve changes in writing.
  2. Copying the old system: rebuilding every legacy screen in Odoo wastes budget; adopt standard flows first.
  3. Dirty data: messy records give you a messy Odoo, so clean and de-duplicate before you move.
  4. Big imports in one go: Odoo's own docs advise to import in smaller batches when files get large.
  5. Wrong import order: load parent records first; one forum user hit an error on every run importing contacts linked to companies in one file.
  6. Vendor-only testing: if your staff never test real scenarios, they find the gaps after go-live.
  7. Training too late: a system nobody adopts is a failed project, however well it was built.
  8. No sponsor: calls on scope, priorities and go-live need someone with authority.

For the full list with fixes, read Odoo implementation mistakes: 10 causes of failure and their fixes.

Odoo implementation by industry: where the effort goes

The phases stay the same in every industry, but the cost and risk sit in different places. Use this table to see where your project will need the most attention.

IndustryPain or cost driverOdoo approachHow iVentureTeam helps
Wholesale and distributionStock accuracy across warehousesInventory routes, barcode, reordering rulesDesign routes, migrate stock and prices
ManufacturingBills of materials and costingManufacturing, Quality, MaintenanceMap production, set up work orders
Retail and eCommerceOrders from several channelsPOS, Website and Inventory in one databaseConnect channels to one stock ledger
Professional servicesTime capture and billingProjects, Timesheets, InvoicingSet up billing rules and approvals
ConstructionJob costing and progress billingProjects, Purchase, analytic accountingStructure jobs and cost codes

After go-live: adoption, support and continuous improvement

The project is not done at go-live; the value comes from adoption, support and steady improvement over the following months. This is where many owners lose momentum.

Keep a support line open for the first weeks, watch which features people avoid and fix the friction. Then add the next app or automation once the last one has stuck.

Plan for version upgrades too. Odoo gives each major version standard support for three years after release. Odoo also says a production upgrade cannot be reverted, so always test first.

Light customization keeps those upgrades affordable. If you can point to one process that is measurably better a month after go-live, the project is on track.

How iVentureTeam helps SMBs with the Odoo implementation process

Budgeting Odoo? Price it in minutes

iVentureTeam scopes, implements and supports Odoo for SMBs and mid-sized companies, so owners get a rollout that fits their risk, budget and timeline. We have delivered 150+ ERP projects across 35+ countries with 40+ Odoo specialists over 13+ years.

  • Discovery and scope: process mapping, a written scope and a staged plan before any build starts.
  • Rollout design: phased, big-bang or hybrid, chosen around your risk and cash flow.
  • Data migration: cleaning, mapping and loading from Tally, QuickBooks, Xero or spreadsheets.
  • Training and testing: role-based training and scenario testing with your own staff.
  • After go-live: hypercare and ongoing Odoo implementation services as you add apps.

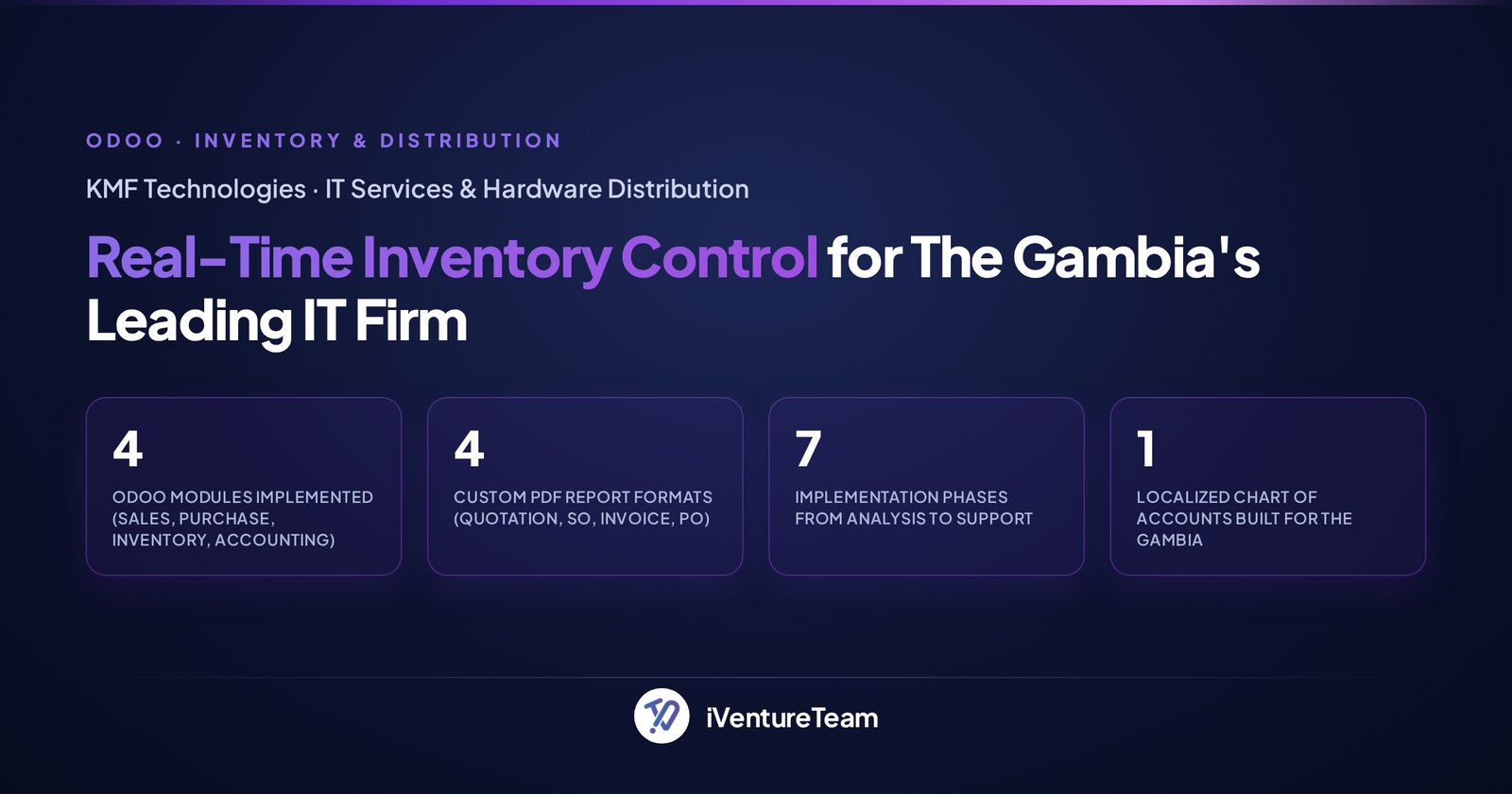

Odoo implementation process case study: KMF Technologies

KMF Technologies, an IT services and hardware distributor in The Gambia, replaced manual stock tracking with Odoo in an 8-week phased rollout. It shows the phases above working in order.

KMF tracked products and categories by hand, had no real-time stock visibility, and its sales, purchase and store teams could not see each other's data. Customers waited while staff checked with each team.

We ran a seven-phase implementation, from requirements and system design to training and post-go-live support, across Sales, Purchase, Inventory and Accounting. We imported the full product master with integrity checks and built a chart of accounts for The Gambia.

After a phased go-live, KMF runs an integrated purchase-to-delivery workflow with live stock. Its director said: "We went from guessing stock levels to trusting them." Read the KMF Technologies Odoo inventory implementation case study.

The bottom line on a successful Odoo implementation

A successful Odoo implementation process is won on owner decisions: the right rollout strategy, an honest budget, a proven partner, tight scope and real change management. Get those right and Odoo delivers.

You do not need to become technical. Pick the strategy, budget against real ranges, protect the scope and stay engaged through go-live. Do that, and Odoo becomes the system your business runs on.

Ready to plan your Odoo implementation?

Plan my Odoo rollout

Get a written scope, rollout plan and cost range for your business. Plan your Odoo rollout with a senior consultant, call +91-90235-15208, or email business@iventureteam.com.

Frequently Asked Questions

How long does an Odoo ERP implementation take?

+

A focused single-entity Odoo implementation on standard modules can go live in 4 to 8 weeks, while multi-entity or heavily customized projects take 3 to 6 months. The biggest factor is scope discipline. iVentureTeam recently took a Gambian IT distributor live in an 8-week phased rollout.

How much does an Odoo implementation cost?

+

Most SMB Odoo implementations run $5,000 to $45,000 over 4 to 14 weeks, depending on scope, customization, users, and integrations. Odoo licenses are billed separately at about $31 per user per month. Treat unusually low quotes with caution.

Should I choose Odoo Community or Enterprise?

+

Community is free and open source, covering core sales, inventory, and basic invoicing. Enterprise is paid, about $31 per user per month, and adds full accounting, Studio, mobile apps, and support. Most growing SMBs pick Enterprise; Community suits simpler, budget-tight setups.

What is the best Odoo implementation strategy, big-bang or phased?

+

For most SMBs, a phased rollout is safest because it limits risk and lets the team adjust. Big-bang is faster and cheaper but riskier, and a parallel run is safest but costliest. Choose based on how much a bad week would hurt the business.

Why do Odoo implementations fail?

+

They rarely fail on the software. The common causes are scope creep, poor data quality, weak training and change management, no executive sponsor, and choosing the cheapest partner. Each of these is a management issue an engaged owner can prevent.

Do I need a partner, or can I implement Odoo myself?

+

A very small business on standard modules can self-implement, but most SMBs benefit from a partner for scoping, data migration, customization, and training. The partner reduces risk and time; just choose on references and a clear scope, not price.

What roles do I need on my team for an Odoo implementation?

+

Name an executive sponsor (usually the owner), process owners for each area like sales and accounting, a data owner to clean and approve migrated records, and a few testers. The partner builds Odoo, but these people make sure it fits your business and gets adopted.

What does an owner need to do during an Odoo implementation?

+

Set the goals and scope, choose the rollout strategy and partner, approve or reject customizations, make sure your team tests and trains, and sign off on go-live. You do not configure Odoo, but you make the decisions that decide whether it succeeds.
